Bujagali first 50MW ready in Oct

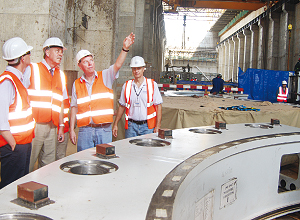

German Team Inspects Equipment at Bujagali Uganda

German Team Inspects Equipment at Bujagali Uganda

Monday, 14th February, 2011

THE River Nile will for the second time in three years undergo a landmark diversion as construction of the 250MW Bujagali Hydropower project gets into its final stage.

Top Bujagali Energy officials, the major sponsors of the multi-billion project, said the diversion that begun yesterday would involve the blocking of the east waterway of the river to allow works commence on the right and final embankment.

“The west channel, which has been closed to river flow for the past three years to permit the construction of key structures, will be opened, while the east channel will be blocked upstream and downstream,” Bill Groth, the construction manager, said.

He noted that the water deflection activities that will take place for several weeks will eventually divert the entire river waters through the newly-constructed concrete spillway.

Once the river is diverted, the final phase of the construction will be achieved.

The river was first diverted in September 2007 to create a dry channel where the powerhouse would be erected.

About 90% of the structural concrete on the powerhouse has been completed, while almost all the required electrical mechanical equipment (98%) for it have been delivered on site, Groth said.

He described this as a “milestone” in the construction of the hydroelectric power project which is expected to double the generation capacity and reduce dependency on the costly thermal generation.

“This is an important phase because the powerhouse where the turbines are being installed is also approaching completion.

“We expect the first unit generation of 50MW around October, which again is a milestone in this project,” Groth disclosed.

He added that after the first unit goes online, the remaining four units of 50 MW each will be commissioned consecutively after thorough tests.

The project is expected to be fully commissioned by April 2012.

Groth revealed that 75% of the total project is complete with 95% of the switchyard civil works done and 75% of the electromechanical works accomplished.

Groth urged rafters, kayakers, boaters, swimmers, fishermen and tour operators using the Upper Nile River to avoid the diversion area as the river flow will be highly turbulent and unpredictable during the water diversion.

“After February 15, it will not be possible to travel down the river past the project site.

“For safety reasons, we advise all users to exit the river well upstream of the diversion area,” he said.

The deputy construction manager, Kenneth Kaheru, allayed fears that rafting, which is popular with tourists, would come to a complete end with the river diversion.

He said the rafting activities would move to downstream at the Kalagala offset which is being developed as a recreation and tourist attraction.

By Frank Mugabi The New Vision Newspaper

Click here to post comments

Join in and write your own page! It's easy to do. How? Simply click here to return to Africa Uganda Business Travel News .





Haven't yet found what you Want...?

If you haven't yet found what you were looking for or you need detailed information about the subject matter on this page

then...

feel free to ask our business travel consultants.



Enjoy this page? Please pay it forward. Here's how...

Would you prefer to share this page with others by linking to it?

  1. Click on the HTML link code below.
  2. Copy and paste it, adding a note of your own, into your blog, a Web page, forums, a blog comment, your Facebook account, or anywhere that someone would find this page valuable.
